Sister County Construction Litigation Guides Across Northern Virginia
Construction disputes follow different patterns across Northern Virginia depending on the county’s market profile, court system, and dispute volume. For comparable analysis in the other three priority counties:
Loudoun County Construction Litigation Lawyer — Ashburn data center construction, Brambleton and Stone Ridge residential, and rural west custom homes in Aldie, Middleburg, and Purcellville.
Fairfax County Construction Litigation Lawyer — Tysons commercial buildouts, Reston technology campuses, McLean residential, and the highest construction dispute volume in the Commonwealth.
Arlington County Construction Litigation Lawyer — Pentagon City and Crystal City high-rise condo work, Rosslyn-Ballston corridor mid-rise renovations, and pre-1985 building asbestos issues.
Prince William County Construction Litigation Lawyer: A Complete Guide to Contract Disputes, Defects, Liens, and Change Orders
By Anthony I. Shin, Esq. | Civil Litigation & Construction Disputes | Shin Law Office
BOTTOM LINE UP FRONT

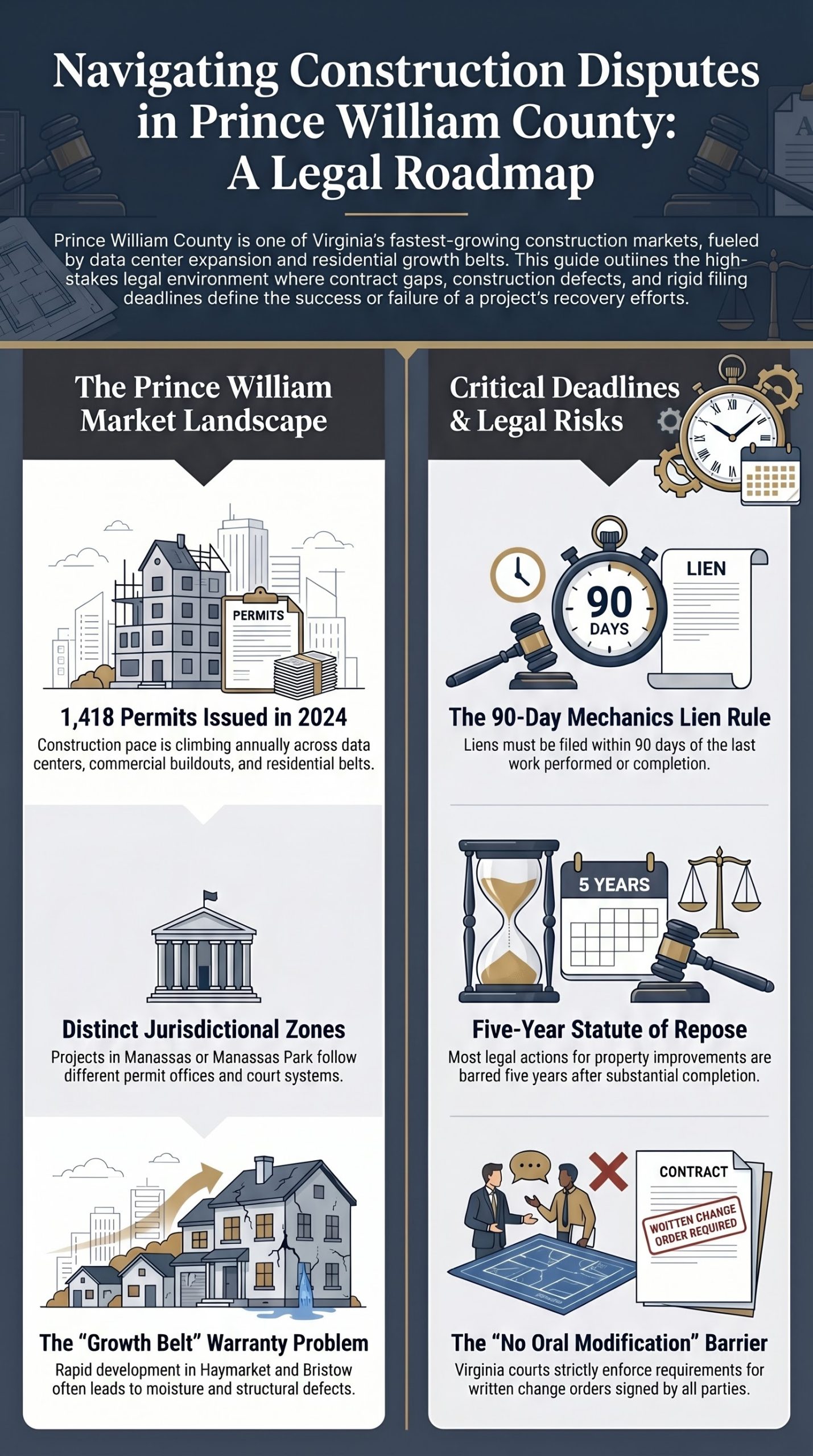

Prince William County is one of the fastest-growing construction markets in Virginia. One thousand four hundred eighteen building permits were issued in 2024, and the pace has been climbing every year. The work runs from data center expansion at Innovation Park near Manassas, to commercial buildouts along the I-95 corridor in Woodbridge and Dale City, to the active residential construction of the Bristow, Gainesville, and Haymarket growth belt, to custom homes in the rural west around Nokesville and Catlett. Underneath all of it lies the controversial Prince William Digital Gateway, the proposed data center expansion that has reshaped land-use politics across the county.
As a Northern Virginia attorney representing developers, owners, contractors, and subcontractors across Prince William, I built this guide to walk through the patterns I see most often: contract fights, defect cases, mechanics lien claims, change order battles, cost overrun and schedule delay damages, and subcontractor payment disputes.
If your dispute involves a notice, a pay application, a lien deadline, or a court filing, time is already working against you. Call 571-445-6565 or contact Shin Law Office today to discuss your situation.

Table of Contents
- Prince William County’s Construction Markets and What They Produce
- Construction Contract Disputes
- Construction Defects in Prince William
- Mechanics Liens and Payment Disputes
- Change Order and Scope Disputes
- Cost Overruns and Schedule Delay Damages
- Subcontractor and Supplier Disputes
- Virginia Construction Law Foundations
- Navigating Prince William County Courts
- How Shin Law Office Resolves Prince William Construction Disputes
Chapter 1: Prince William County’s Construction Markets and What They Produce
Prince William County is three construction markets layered into a single jurisdiction. The eastern I-95 corridor along Woodbridge, Dale City, Lake Ridge, and Triangle is an established suburban and industrial market, with mature commercial corridors, residential rental properties, and steady commercial development. The central growth belt around Manassas, Bristow, Gainesville, and Haymarket is one of the fastest-growing residential and mixed-use markets in Virginia, with active subdivision development, builder warranty volume, and HOA architectural review activity. The rural west around Nokesville, Catlett, and the unincorporated agricultural areas runs custom homes, agricultural construction, and the occasional larger commercial project on land that has historically traded at lower density.
Layered on top of all three is the pressure from the data center. Innovation Park near Manassas hosts an active and growing data center footprint. The proposed Prince William Digital Gateway redesignations along the Pageland Lane corridor have created one of the most actively litigated land-use environments in the Commonwealth. Construction work tied to data center development carries its own contract patterns, scheduling pressure, and specialty subcontractor exposure.
All of these markets feed cases into the Prince William County Circuit Court in Manassas. Smaller cases valued at less than the jurisdictional limit are heard in the Prince William County General District Court. Mechanics lien cases involve filing in the Circuit Court land records before any litigation begins.
Two independent cities sit inside the county footprint:
The City of Manassas and the City of Manassas Park are independent jurisdictions surrounded by Prince William County. Each has its own permit office, zoning ordinance, and court system. A construction project inside city limits is subject to that city’s permit and inspection process, and litigation is filed in that city’s Circuit Court rather than the Prince William County Circuit Court. The first question I ask in any new case is which jurisdiction the project actually sits in.
For the broader civil litigation context surrounding construction work in this county, see my companion Prince William County property dispute lawyer guide, which covers boundary, easement, zoning, adverse possession, and quiet title actions involving the same parcels where construction disputes often arise. For appellate work specific to construction cases, see my construction defect and change order appeals guide. For comparison with neighboring jurisdictions, see my Loudoun County construction litigation lawyer guide and Fairfax County construction litigation lawyer guide. The chapters that follow drill into the specific construction dispute patterns I see most often in Prince William.
Chapter 2: Construction Contract Disputes
Most construction disputes in Prince William County stem from the contract. The contract is what the parties signed at the beginning of the project. The dispute arises when the project does not behave as anticipated under the contract. Whether the issue is a missed deadline, a rejected pay application, a scope dispute, a defective installation, or a refusal to release retainage, the analysis starts with what the contract says, what it does not say, and what Virginia law fills in for the gaps.
Why Prince William Contract Disputes Are Often the Worst Kind
Prince William’s residential construction market has a particular weakness that produces some of the worst contracts I see in any Northern Virginia jurisdiction. Homeowners hire local builders for additions, renovations, and custom homes on the strength of personal references and a quick walk-through of prior work. The contract that follows is often two pages, typed on the contractor’s letterhead, with no completion deadline, no liquidated damages provision, no retainage requirement, and a payment structure heavily front-loaded in favor of the contractor.
A Woodbridge homeowner found this out on a $380,000 addition project. Eight months into a six-month project, with $290,000 already paid, the contractor stopped showing up. The contract had no completion deadline, no liquidated damages, no retainage requirement, and a payment structure that had already paid out most of the contract value before substantial work was complete. The full case documents how a Woodbridge homeowner signed the wrong contract and paid for it three times.
Common Prince William Construction Contract Issues
The recurring contract issues in Prince William fall into a few categories. Missing protective provisions on residential contracts that should include completion deadlines, retainage, and liquidated damages, but do not. No damage for delay clauses on commercial contracts that prevent contractors from recovering money for delays caused by the owner or third parties. Pay if paid clauses tie subcontractor payment to the general contractor receiving payment from the owner. Indemnity provisions that shift liability for the owner’s or designer’s errors onto the contractor. Termination-for-convenience provisions that let owners end the contract without cause but limit what the contractor can recover. Dispute resolution clauses that can require arbitration in distant forums, waive jury trial rights, or impose short notice deadlines.
Available Causes of Action
Virginia recognizes breach of contract, breach of express and implied warranties, fraudulent inducement, negligent misrepresentation, mutual mistake, unconscionability, violations of the Prompt Payment Act, and quantum meruit recovery for work performed without a binding contract. Which causes of action are available depends on what the contract says, what was promised outside the contract, and how the project actually unfolded. Where consumer construction transactions involve fraud or deception, the Virginia Consumer Protection Act may also apply, with treble damages and attorneys’ fees available in qualifying cases.
Chapter 3: Construction Defects in Prince William
A construction defect is the building telling you the truth about how it was actually designed, built, and supervised. Cracks, leaks, settlement, mold, structural movement, mechanical failures, and finish failures are all evidence. Virginia gives owners and associations a limited window to investigate, document, and act, and the deadlines run faster than most people expect.
Patent vs. Latent Defects
Virginia law distinguishes patent defects, which are visible on reasonable inspection, from latent defects, which are hidden behind walls, beneath slabs, or inside mechanical systems and would not be discovered by a reasonable inspection. The distinction matters because the discovery rule for latent defects can extend the statute of limitations period, while patent defects are subject to ordinary limitations starting from completion. The line between patent and latent is often the central battleground in a defect case. For a foundational discussion, see my piece on how construction defects are evidence of how a project was really built.
Haymarket and the Growth Belt Warranty Problem
The Bristow, Gainesville, and Haymarket growth belt has produced a steady volume of new construction warranty disputes. New homes go up fast, new owners move in, and within eighteen to thirty months the moisture intrusion, HVAC failures, foundation cracking, and exterior trim separation issues start showing up. The builder warranty response is often slow or inadequate, with weeks-long delays between inspection visits, denied claims due to technicalities, and remediation work that does not actually fix the underlying problem. I have written about a Haymarket homeowner case in Haymarket’s fastest growing neighborhood has a warranty problem no one is talking about.
Manassas Commercial Defects and the Latent Discovery Window
Commercial defect cases in Manassas, Manassas Park, and along the I-95 corridor often surface after the standard one-year warranty has expired. The building passes every inspection, gets occupied, and then the structural movement, partition misalignment, or mechanical issues begin to develop progressively over time. By the time the tenant or owner identifies the underlying problem, the express warranty has run and the case has to proceed under Virginia’s latent defect framework and statute of repose. I have documented one such case in the Manassas commercial build out that looked finished until the walls started moving.
Older Eastern Prince William Defects
In the older eastern Prince William residential neighborhoods of Woodbridge, Dale City, and Lake Ridge, defect cases tend to involve renovation and addition work on existing housing stock rather than new construction. Roof and gutter failures from improper flashing, basement waterproofing failures from inadequate grading, deck and porch framing that does not meet current code, and electrical and plumbing upgrades that do not match the existing systems all produce litigation. Virginia’s implied warranties for new construction do not always apply to renovation work, making contract terms even more important.
The defect clock starts running before you notice the defect:
Virginia’s statute of limitations for breach of contract on a written agreement is five years. Virginia’s statute of repose under Va. Code Section 8.01-250 generally limits actions for damages arising out of improvements to real property to five years after substantial completion. Once the clock runs, even meritorious claims are barred. The earlier you document, investigate, and act, the more rights you preserve.
Chapter 4: Mechanics Liens and Payment Disputes
A mechanics lien in Virginia is a contractor’s, subcontractor’s, or supplier’s most powerful payment remedy. The lien attaches to the real property where the work was performed and creates a security interest that can ultimately be foreclosed if the debt is not paid. The lien is also one of the most procedurally unforgiving remedies in Virginia practice. Miss a deadline by a single day, and the lien is invalid.
The Lien Statute and the Ninety-Day Rule
Virginia’s mechanics lien statute, codified at Va. Code Section 43-1 and following, requires the lien claimant to file a memorandum of mechanics lien in the Prince William County Circuit Court land records within ninety days of the last day of the month in which the claimant last performed labor or supplied materials, and within ninety days of the project’s substantial completion. Properties inside the City of Manassas or Manassas Park file in those independent cities’ Circuit Courts instead. The lien must include specific information identifying the property, the parties, the work performed, the amount owed, and the relevant dates. After the lien is recorded, the claimant has 6 months to file a bill in equity to enforce it, or it expires.
Payment Bond Claims on Bonded Projects
On bonded projects, including most public construction work and many large private projects, payment bond claims under the Little Miller Act for state work or the Miller Act for federal work provide a parallel remedy. The notice requirements differ from the mechanics lien requirements; the time limits differ, and the procedural posture differs. Federal projects on Quantico, work tied to federal facilities elsewhere in Prince William, and work on county or state projects all carry bond claim implications. I have written specifically about Woodbridge bond disputes, including how Woodbridge developers can navigate payment bond disputes without derailing the project.
The Virginia Prompt Payment Act
Virginia’s Prompt Payment Act sets statutory time limits on payments down the construction chain and provides interest and other remedies for late payment. On private projects, owners must pay general contractors within 45 days of receipt of an invoice, and general contractors must pay subcontractors within 7 days of receiving payment from the owner. Failure to comply produces interest at the legal rate and, in some cases, attorneys’ fees. The Act does not replace the mechanics lien remedy, but it can be used in parallel.
Chapter 5: Change Order and Scope Disputes
A change order is the formal mechanism for modifying the scope of work, the contract sum, or the contract time after the construction contract is signed. In a perfectly run project, every scope change is documented in a written change order signed by the owner, the architect, and the contractor before the work is performed. In a real Prince William project, change orders receive verbal approval; written approval comes later, if at all; and the contractor performs the work in good faith, expecting payment.
The Written Change Order Requirement
Most construction contracts require change orders to be in writing and signed before the work is performed. The contract often contains a no-oral-modification clause stating that it cannot be amended verbally. Virginia courts generally enforce these provisions. When a contractor performs work without a written change order, the contractor faces an uphill battle to get paid for that work, even if the owner asked for it. The available legal theories include waiver of the writing requirement based on the parties’ course of conduct, equitable estoppel based on detrimental reliance, and quantum meruit recovery for the reasonable value of the work performed.
Constructive Change Orders
A constructive change order is work performed because of an owner’s directive or interference that effectively requires extra work or extra time, even though no formal change order was issued. Examples include differing site conditions the owner did not disclose, defective design documents that required additional work to make them functional, owner interference with the contractor’s planned sequence, and overinspection that imposed standards beyond those required by the contract. Virginia recognizes constructive change order claims, but the contractor has to give timely notice and document the additional cost as it is incurred.
Cumulative Impact Claims
When a project experiences a large number of individual change orders, the cumulative effect on productivity, sequencing, and overhead can exceed the sum of the individual changes. Virginia recognizes cumulative impact claims, but they require careful documentation, expert testimony, and a methodology that the court will accept. These cases often turn on the contractor’s ability to prove the baseline productivity, the actual productivity during the impacted period, and the causal connection between the changes and the lost productivity.
Chapter 6: Cost Overruns and Schedule Delay Damages
Cost overruns and schedule delays are the most common sources of large construction disputes in Prince William County. Innovation Park data center work, growth belt residential subdivisions, I-95 corridor commercial buildouts, and rural west custom homes all run on budgets and schedules that can break in different ways.
Liquidated Damages
Most construction contracts include a liquidated damages provision that imposes a fixed daily amount for each day the project runs past the contract completion date. Virginia courts enforce liquidated damages provisions that represent a reasonable estimate of actual damages and are not so disproportionate to actual harm as to constitute a penalty. The contractor’s available defenses include excusable delay, owner-caused delay, concurrent delay, and challenges to the reasonableness of the liquidated damages rate itself.
Actual Delay Damages
When the contract does not include a liquidated damages provision, or when the provision is unenforceable, the owner can pursue actual damages for delay. These damages typically include lost rent, lost revenue, additional financing costs, and additional supervision and management costs. Proving actual delay damages requires expert testimony, financial records, and a clear causal connection between the delay and the claimed loss.
No Damage for Delay Clauses
Many Prince William construction contracts include no-damage-for-delay clauses that purport to bar the contractor from recovering monetary damages for delays caused by the owner. Virginia courts generally enforce these clauses, but several recognized exceptions can apply: delays caused by the owner’s bad faith, delays not contemplated by the parties, delays so unreasonable as to amount to abandonment, and delays caused by the owner’s active interference with the contractor’s work. The contractor’s ability to invoke an exception depends heavily on the project record and contemporary documentation.
Critical Path Analysis and Time Extensions
When a delay occurs, the contractor’s first response is usually a request for a time extension under the contract’s change order procedure. Whether the contractor is entitled to an extension depends on whether the delay was on the critical path, whether the delay was excusable, and whether the contractor gave timely notice. Critical path analysis using project scheduling software has become a standard expert tool in Virginia delay cases.
Chapter 7: Subcontractor and Supplier Disputes
Subcontractors and suppliers carry the most exposure on a construction project and the least leverage. They are paid last, they have the smallest margins, and they have the fewest contractual rights against the upstream parties whose decisions affect the work most. Prince William’s growth belt construction volume produces a steady stream of these disputes.
Pay if Paid vs. Pay When Paid
A pay-if-paid clause states that the general contractor is required to pay the subcontractor only when the GC receives payment from the owner. A pay when paid clause says the GC will pay the subcontractor when the GC receives payment from the owner, but does not condition payment on receipt. The legal effect is dramatically different. Pay-if-paid clauses transfer the risk of owner nonpayment from the GC to the subcontractor. Pay when paid clauses do not. Virginia courts generally enforce pay-if-paid clauses if the contract language is clear and unambiguous.
Bond Disputes on Federal and Public Projects
Prince William hosts significant federal land at Quantico and Manassas Battlefield Park, and federal contract work in the county routinely involves Miller Act bond claims when prime contractors fail to pay. State and county public projects similarly require Little Miller Act bonds. The notice and timing rules for bond claims are different from mechanics lien rules, and a subcontractor on a bonded project who only knows lien procedure can lose the bond remedy by missing the federal notice deadlines.
Backcharge Defenses
When the GC asserts a backcharge against a subcontractor, the subcontractor has several available defenses. Lack of notice, lack of opportunity to cure, failure to mitigate damages, lack of contractual basis for the charge, and unreasonable cost calculations are all common. The contract often dictates the procedure the GC must follow before imposing a backcharge, and a backcharge that skips required steps may not be enforceable.
Chapter 8: Virginia Construction Law Foundations
Every Prince William construction dispute rests on the foundation of Virginia substantive law. The five concepts below are the ones I find myself explaining most often to new clients, and the ones that most often determine the outcome of a case before trial begins.
Statutes of Limitation
Virginia construction practice operates on a tight set of limitations periods. Breach of a written contract has a five-year limitation period under Va. Code Section 8.01-246. Breach of an oral contract has a three-year period. Fraud claims have a 2-year discovery period. Negligence claims have a two-year period for personal injury and a five-year period for property damage. The mechanics lien window is ninety days from last work, and the bill in equity to enforce the lien must be filed within six months of recording.
Statute of Repose
Virginia’s statute of repose for actions arising out of improvements to real property, codified at Va. Code Section 8.01-250, generally limits actions for damages to five years after the project’s substantial completion. Unlike a statute of limitations, the statute of repose runs from completion regardless of when the defect was discovered.
Implied Warranties
Virginia law implies warranties on new home construction that the home will be built in a workmanlike manner and will be habitable. These warranties run from the builder to the original purchaser and to subsequent purchasers within the warranty period. The implied warranties exist independently of any express warranty and cannot be disclaimed without specific language. Implied warranty claims are often the strongest claims a homeowner has in a residential construction defect case, particularly in Prince William’s growth belt, where new construction volume is highest.
Available Remedies
Virginia courts have a full set of remedies available in construction cases. Money damages compensate for the cost to repair, the diminution in value, lost use of the property, additional financing costs, and consequential damages where contractually permitted. Specific performance is rarely available. Rescission can undo a contract that was procured by fraud. Mechanics’ liens provide security for unpaid claims. The Virginia Consumer Protection Act provides additional remedies, including treble damages and attorneys’ fees, in cases involving consumer transactions.
Punitive Damages and Attorneys Fees
Punitive damages are available in construction cases involving fraud, willful misconduct, or other intentional torts, but Virginia caps punitive damages at $350,000 per case, per defendant. Attorneys’ fees are not generally recoverable in Virginia unless the contract authorizes them or a specific statute provides for them. The Prompt Payment Act, the Virginia Consumer Protection Act, and certain bond claim statutes are common sources of statutory attorneys’ fees.
Chapter 9: Navigating Prince William County Courts
Where you file a Prince William construction dispute matters as much as how you file it. Each forum has its own procedures, monetary limits, and pace. The independent cities of Manassas and Manassas Park add a jurisdictional layer that is absent in most Virginia counties.
Prince William County General District Court
The General District Court hears civil cases up to a $25,000 jurisdictional limit. The court is housed in Manassas and moves at a faster pace than the Circuit Court. Trials are bench trials, meaning a judge decides the case without a jury. Smaller construction payment disputes, supplier disputes within the cap, and warranty matters within the limit can move efficiently through this court.
Prince William County Circuit Court
The Circuit Court is the trial court of general jurisdiction for Prince William County. Mechanics’ lien enforcement actions, large breach-of-contract cases, defect cases requiring expert testimony, and any matter involving title to land or equitable relief are filed here. The Circuit Court conducts both bench trials and jury trials.
Manassas and Manassas Park Courts
If your project is within the City of Manassas or the City of Manassas Park, the case goes to the Manassas Circuit Court or the Manassas Park Circuit Court, rather than to the Prince William County Circuit Court. Each independent city has its own General District Court and Circuit Court, its own zoning ordinance, and its own land records. The first procedural question in any case involving these areas is which jurisdiction the property is actually in.
Federal Court and the Eastern District of Virginia
Construction disputes occasionally end up in the United States District Court for the Eastern District of Virginia, which is housed in the Albert V. Bryan Federal Courthouse in Alexandria. Federal jurisdiction exists when the parties are from different states and the amount in controversy exceeds $75,000, or when the case presents a federal question such as a Miller Act payment bond claim on a federal project. Prince William construction cases tied to federal land at Quantico, federal contracts elsewhere in the county, or out-of-state parties often end up in this court.
Arbitration and Mediation
Many Prince William construction contracts include mandatory arbitration provisions that send disputes to AAA, JAMS, or another arbitral forum rather than to court. Arbitration has different rules, evidence standards, discovery limits, and appeal rights than litigation. Mediation is often required as a precondition to arbitration or filing suit, and many cases resolve at mediation before consuming the expense of a full hearing.
Chapter 10: How Shin Law Office Resolves Prince William Construction Disputes
My approach to a Prince William construction case follows the same five-step process, whether the matter is a homeowner addition gone bad or a multimillion-dollar Manassas commercial defect case.
Step one is the document review. Before I can give a client a meaningful assessment, I need to see the contract, change orders, project schedule, pay applications, daily reports, RFI log, submittal log, punch list, warranty correspondence, and any expert reports already commissioned. Most construction cases are won and lost on the contemporaneous documentation, and the earlier I see what exists, the better.
Step two is the factual investigation. Site visits, photographs, conversations with project participants, and interviews with the people who were on the project day to day produce the evidence that fills in what the documents do not capture. Construction cases rely heavily on what a competent observer would have noticed and how the parties’ conduct departed from what the contract required.
Step three is the legal analysis. With the documents and the facts in hand, I can map the case onto Virginia law. Which causes of action are available? Which defenses does the other side have? What expert testimony will the case require? What is the realistic timeline and cost? Where should the case be filed, and on what theory? These questions get answered before any complaint is drafted.
Step four is the resolution effort. Most construction disputes are resolved before trial. A clear, well-documented demand letter that lays out the legal position and the evidence often produces a workable settlement. Mediation is often required by the contract and often produces a resolution at a fraction of the cost of full litigation. I push for resolution wherever resolution is achievable on terms my client can accept.
Step five is litigation when litigation is the only path forward. When the other side refuses to engage in good faith, when the legal issues require a court order, or when the client’s rights cannot be protected outside court, I file the case and try it.
Summary: What to Take Away From This Guide
Three principles run through every chapter of this guide. The first is that time matters more than people realize. Mechanics lien deadlines, prompt payment deadlines, statutes of limitation, and the five year statute of repose all operate on rigid timelines. The day a Prince William construction dispute begins is the day the clock starts running on at least one of these timelines.
The second is that documentation matters more than memory. Contracts, change orders, pay applications, daily reports, schedules, and contemporaneous correspondence carry weight in court that recollections of phone calls and site meetings simply do not. The contract decides cases. Documentation tells the court what the contract really meant in practice.
The third is that forum matters. Whether your case belongs in the Prince William County General District Court, the Prince William County Circuit Court, the Manassas or Manassas Park courts, the Eastern District of Virginia, an AAA or JAMS arbitration, or in mediation depends on the relief you need, the amount at stake, the contract’s dispute resolution provisions, and the procedural posture.
Frequently Asked Questions
How long do I have to file a mechanics lien in Prince William County?
Virginia’s mechanics lien statute requires the memorandum of lien to be filed in the Prince William County Circuit Court land records within ninety days of the last day of the month in which the claimant last performed labor or supplied materials, and within ninety days of the project’s substantial completion. After the lien is recorded, a bill in equity to enforce the lien must be filed within six months of recording. Both deadlines are jurisdictional. Properties inside the City of Manassas or Manassas Park file in those independent cities’ Circuit Courts.
My Haymarket builder warranty expired but I just discovered the defect. Do I have any options?
Possibly. Express warranties expire on a fixed timeline, but Virginia recognizes implied warranties on new construction that can extend further. Virginia’s statute of limitations for breach of contract is five years, and the discovery rule for latent defects can extend the period in certain cases. Virginia’s statute of repose at Va. Code Section 8.01-250 generally caps actions at five years from substantial completion. Whether you have a viable claim depends on the facts, the warranty language, and how recently the defect was discoverable.
Does my Prince William property fall in the county or in Manassas?
The City of Manassas and the City of Manassas Park are independent jurisdictions surrounded by Prince William County. Each has its own permit office, zoning ordinance, and court system. A construction project inside city limits answers to that city’s permit and inspection process, and litigation goes to that city’s Circuit Court. Verifying the actual jurisdiction is the first step in any Prince William area construction case.
Can I recover for work I performed without a written change order?
It depends on what the contract says, what the parties did, and whether you gave timely notice. Virginia generally enforces no oral modification clauses, but available legal theories include waiver based on the parties’ course of conduct, equitable estoppel based on detrimental reliance, and quantum meruit recovery for the reasonable value of the work. The contractor’s documentation during the project is critical.
My residential contract has no completion deadline or retainage. Can I still get out of it?
Virginia recognizes contract defenses based on unconscionability, fraud in the inducement, and the contractor’s material breach. A contract that lacks basic protective provisions and establishes a payment structure in which the homeowner pays most of the contract price before substantial completion may give rise to several legal theories. The viability of any specific approach depends on the contract language and the project’s facts.
What is a no damage for delay clause, and is it enforceable in Virginia?
A no-damage-for-delay clause purports to bar the contractor from recovering monetary damages for delays caused by the owner. Virginia courts generally enforce these clauses, but recognized exceptions can apply: delays caused by the owner’s bad faith, delays not contemplated by the parties, delays so unreasonable as to amount to abandonment, and delays caused by the owner’s active interference. Whether an exception applies depends on the project record and contemporary documentation.
Does the Virginia Consumer Protection Act apply to construction defects?
The Virginia Consumer Protection Act can apply to consumer construction transactions involving misrepresentation, fraud, or other deceptive practices. The Act provides for actual damages, treble damages in certain cases, and attorneys’ fees. Whether the Act applies to a specific case depends on the nature of the transaction, the parties involved, and the conduct alleged. Most pure breach-of-contract cases are not VCPA cases, but cases involving fraudulent inducement, concealed defects, or deceptive practices may qualify.
My project is on Quantico or another federal site. Are the rules different?
Yes. Federal projects are governed by the federal Miller Act for payment bond claims rather than state law mechanics liens, and federal procurement disputes can implicate the Contract Disputes Act and other federal procurement frameworks. The notice requirements, time limits, and procedural posture differ. Federal jurisdiction often applies, and cases proceed in the United States District Court for the Eastern District of Virginia rather than in state court.
How long does a Prince William construction case typically take?
A General District Court case typically reaches resolution within three to six months. A Circuit Court construction case typically takes twelve to twenty-four months from filing to trial, though many resolve through mediation or settlement before trial. Cases involving multiple parties, complex defect issues, or significant expert testimony can take longer. Arbitration timelines vary by forum but are often faster than full Circuit Court litigation.
What does it cost to hire a construction litigation lawyer in Prince William County?
Cost depends on the complexity of the dispute, the amount of discovery required, whether expert witnesses are needed, and whether the case settles or goes to trial. Construction cases tend to be document and expert heavy, which influences cost more than for many other categories of civil litigation. I provide an initial case assessment and a clear engagement structure so clients know what to expect at each stage. Call 571-445-6565 to discuss your specific situation.
Talk to a Prince William County Construction Litigation Lawyer Today
Construction disputes do not get easier with time. Lien deadlines run, evidence disappears, witnesses move on, and the other side gains the advantage of every day you wait. Whether you are facing a Manassas commercial defect case, a Haymarket warranty dispute, a Woodbridge contract failure, or a custom home overrun in Nokesville, the right time to call is now.
Shin Law Office represents owners, developers, contractors, subcontractors, and suppliers in construction disputes across Prince William County and Northern Virginia. I have handled cases from single family warranty claims to multimillion dollar commercial defect litigation, and I bring the same focused, evidence based approach to every matter.
Call 571-445-6565 or contact Shin Law Office to discuss your Prince William County construction matter.
References
Code of Virginia. (n.d.). Section 8.01-246. Personal actions based on contracts. https://law.lis.virginia.gov/vacode/title8.01/chapter4/section8.01-246/
Code of Virginia. (n.d.). Section 8.01-250. Limitation on actions for damages arising out of defective or unsafe condition of improvements to real property. https://law.lis.virginia.gov/vacode/title8.01/chapter4/section8.01-250/
Code of Virginia. (n.d.). Title 43, Chapter 1. Mechanics’ liens. https://law.lis.virginia.gov/vacodefull/title43/chapter1/
Code of Virginia. (n.d.). Virginia Consumer Protection Act. https://law.lis.virginia.gov/vacodefull/title59.1/chapter17/
Prince William County Government. (n.d.). Circuit Court. https://www.pwcva.gov/department/circuit-court
Prince William County Government. (n.d.). General District Court. https://www.pwcva.gov/department/general-district-court
